Export Packing for Aluminium Windows and Doors: What Buyers Should Check

An export packing checklist for aluminium windows and doors: crate layout, glass protection, labeling, packing lists, container loading, and the pre-shipment records to request.

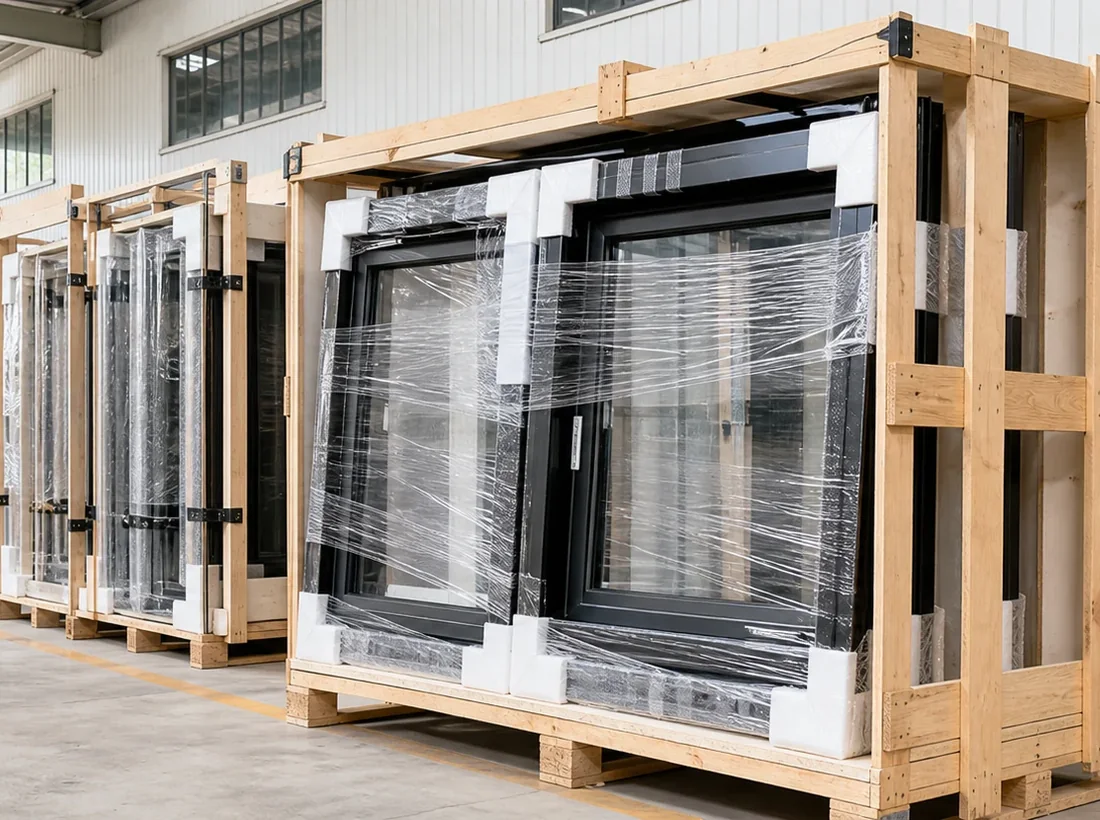

A padded aluminium window frame inside an open timber shipping crate.
Answer in brief

What export packing for aluminium windows and doors needs to cover

Size export crates against the container doorway as well as the cargo volume. Hapag-Lloyd's published 40HQ example has a door opening 2340 mm wide and 2597 mm high. Compare each packed unit and its loading movement with the allocated container before closing the crates.

Select the packing format for site delivery

Receiving situationChooseTrade-off
Mixed sizes going to different floorsCrates grouped by floor with opening-mark labelsMore separation at packing, less sorting at site
Large glazed panels handled uprightA supported rack with separators and a defined lifting arrangementRack geometry and handling space consume container floor area
Accessories fitted after unloadingLabelled bags tied to their opening or crateReceiving staff can identify the matching handle, lock or fittings
Several handling stages before site arrivalProtection designed for the complete handling routeExtra packing mass and volume increase freight inputs

Calculate packed volume from outer dimensions

A 2.0 m × 1.2 m × 0.5 m crate takes up 1.20 m³. Always measure the finished package—including skids and overhanging edge guards—to get true volume.

Log gross weight separately. Volume tells you how much space a crate takes; weight and center of gravity dictate how you rig and lift it. Print both next to the crate ID.

Connect crates to opening marks

Mark each window or door tag directly on the wrapped unit and match it to the crate's line item on the packing list. If the site unloads in phases, include the floor or zone.

When packing multiple units in one crate, list each tag and quantity separately. Place the outer label where banding and straps won't cover it.

Stacked cartons and handling equipment inside a container

Protect glass, frame finishes, and loose hardware

Place non-reactive pads between glass faces and aluminium profiles so stacked units cannot rub in transit. Block and brace the assembly at the designated load points.

Bag loose handles, locks, and fittings, tagged by opening mark. Brace flyscreens separately away from protruding hardware. Note which crate holds the hardware bag on the packing list.

Photograph protection before it is concealed

Take photos of the open crate showing corner guards, spacer pads, and unit tags. Photograph it again once sealed and secured inside the container.

On site, check crate IDs and unit counts against the packing list. Before moving damaged crates or missing hardware bags, photograph the issue with the crate label clearly in frame.

Forklift moving palletised cartons into a container

Size the crates to match site unloading gear

Plan the loading order around your site unloading phases. Give the rigging crew the crate weights, lift points, and haul route before they book forklifts or cranes.

Leave working clearance at the container doors and along the site path. Standard shipping line door charts are only rough guides—check the actual container assigned to your shipment against your crate dimensions.

Identify materials touching the glass

Note any film, cork pad, or interleaving that sits directly against the glass, and keep its removal and cleaning specs filed with the crate record.

If crates arrive wet or the glass shows residue, follow those material specs when stripping the wrap and cleaning the unit. Keep the crate tags and photos with any damaged pieces.

Decide whether the unit ships assembled, split or as loose components

State the shipping state beside every opening mark. A fully assembled glazed window needs protection for the finished frame and glass together. A large assembly split at a designed coupling needs separate protection and an identifiable coupling kit. Loose glass creates a different site handling and glazing task. These are different supply scopes even if the completed elevation looks the same.

Ask who installs glazing beads, gaskets, handles, screens and coupling covers after receipt. List the necessary site consumables and equipment in that person's scope. If a proposed split changes a weather joint, obtain the connection section before agreeing to the packing arrangement. Packing convenience cannot settle the structural or drainage detail.

A receiving photograph should make the shipping state obvious. Record any temporary bracing and its removal instructions so the installer does not mistake a transit support for a permanent component.

Illustrative packing release record

This is a hypothetical record, not a completed shipment. Replace the group names and pending entries with the actual order information.

RecordFilled exampleWhat it enables
Opening groupGround-floor fixed and opening assemblies, west elevationSite team can reserve the correct storage bay
Shipping stateGlazed frames; removable handles separately baggedReceiver knows which assembly work remains
IdentificationCrate WEST-A; opening marks on every unit; accessories in WEST-A bagCount and trace units without unpacking every crate
Handling informationGross weight and approved support points entered by packerHandler selects suitable equipment before dispatch
Release conditionOpen-packing photographs accepted; delivery slot still to be confirmedFactory can close crates while dispatch remains on hold

An empty weight field is an unresolved handling question. Ask the packer to complete it; do not estimate the lifting load from glass area or exterior crate dimensions alone.

Check protection where damage is likely to start

Inspect corners, exposed frame ends, handles and projecting tracks before checking the broad faces. These local features can press through soft wrapping or rub against an adjacent assembly even when the outside crate appears intact. Photograph the separators and contact points while they are still visible.

Protection must stay in position during the planned handling. Ask how the unit is restrained against movement and how straps avoid loading an unsupported frame or glazed face. Keep protection clear of labels and lifting instructions. If a decorative finish needs a particular tape or removal method, identify the material rather than assuming every protective film behaves the same.

Keep wet or damaged packaging out of routine acceptance. Record its condition and seek the relevant opening and cleaning instructions before leaving it in storage. A sealed exterior wrapping is not evidence that the contents remained dry throughout transport.

Prepare the receiving team before the truck arrives

Send the final packing list, crate sequence and handling information to the person receiving the load. Check the truck approach, ground bearing conditions, overhead clearance, storage route and access to the intended work area. A container that can reach the property may still be unable to stop beside the unloading equipment.

Agree where the receiver records shortages, visible damage and labels that cannot be read. Preserve the carrier document, photographs and packaging references together. Keep suspected damage identifiable while the responsible parties give instructions; do not discard the crate label after separating the unit from its packaging.

For delivery to more than one building, check whether the requested unloading order is possible from the packed sequence. A later building's frames at the container door can force unnecessary handling of finished units. Revise the load plan before closure when practical.

Pre-dispatch checklist and common errors

Use a packing release checklist: opening quantities match the order; every crate has an identifier; the packing list maps each identifier to its contents; accessory bags and screens are located; gross weights and support points are stated; open and closed packing photographs are retained; the receiver has the unloading instructions; and the delivery destination matches the booking.

A frequent error is to approve a container-volume total without checking individual crates through the doorway. Another is to use a single generic packing description for a mixture of small windows and large doors. Both hide handling differences. Check the actual packed geometry and the handling method for the largest and most awkward units.

Do not treat a photograph of a closed crate as proof of internal protection. Likewise, a complete frame count does not establish that all coupling parts, keys or screens arrived. Close each discrepancy against the relevant packing-list line so a missing accessory does not disappear inside an overall delivery acceptance.

Use the selected configuration for the quotation

Review the casement windows configurations against the opening marks, glass and installation detail in your order. Keep any option change attached to its own drawing revision. Compare the lift-slide doors arrangement when that operating type is specified on the schedule. Send the marked schedule and unresolved items through the project quotation form so the reply can distinguish the base assembly, alternatives, exclusions and items awaiting approval.

Calculate a first container layout from packed dimensions

Use the container loading calculator for an initial rack layout from finished packed dimensions, container-door clearance, weight and freight cost per square metre. Enter the external rack or crate dimensions, not the bare window size. Keep the actual allocated container, handling space, supports, lashing and unloading method as separate checks. A calculated layout is a planning aid; have the packer and carrier confirm the loading arrangement before dispatch.

Working checklist

  • ☐ Reconcile opening marks and quantities against the approved order.
  • ☐ Record shipping state for frames, glass, screens and handles.
  • ☐ Match each accessory bag to its opening and crate.
  • ☐ Record finished packed dimensions, gross weights and support points.
  • ☐ Check allocated container doorway and planned handling movement.
  • ☐ Retain open-packing, closed-crate and loaded-position photographs.
  • ☐ Confirm receiving contact, unloading equipment and storage route.
  • ☐ Keep damage photographs and carrier records with crate identifiers.
